Project complexity and cost escalations in the early design of railway megaprojects

Published online by Cambridge University Press:  02 July 2026

Per Persson Schön*
Affiliation:
Chalmers University of Technology, Sweden Swedish Transport Administration, Sweden
Claudia Eckert
Affiliation:
The Open University, United Kingdom
Adam Mallalieu
Affiliation:
Chalmers University of Technology, Sweden
Dag Bergsjö
Affiliation:
Chalmers University of Technology, Sweden

Abstract:

Large railway projects suffer from major cost overruns and delays, partly due to project complexity. This study explores how such complexity emerges in the early design stages and affects the project outcomes. Data from 14 interviews were compared with four project complexity frameworks. The results indicate that complexity is mainly institutional rather than structural. Optimism bias, fragmented requirement governance, and weak coordination create self-reinforcing loops of cost growth, showing that governance and decision processes, not technical uncertainty, drive early-stage complexity.

Information

Type
SYSTEMS ENGINEERING AND DESIGN
Creative Commons
Creative Common License - CCCreative Common License - BYCreative Common License - NCCreative Common License - ND
This is an Open Access article, distributed under the terms of the Creative Commons Attribution-NonCommercial-NoDerivatives licence (https://creativecommons.org/licenses/by-nc-nd/4.0/), which permits non-commercial re-use, distribution, and reproduction in any medium, provided the original work is unaltered and is properly cited. The written permission of Cambridge University Press must be obtained for commercial re-use or in order to create a derivative work.
Copyright
The Author(s), 2026
Figure 0

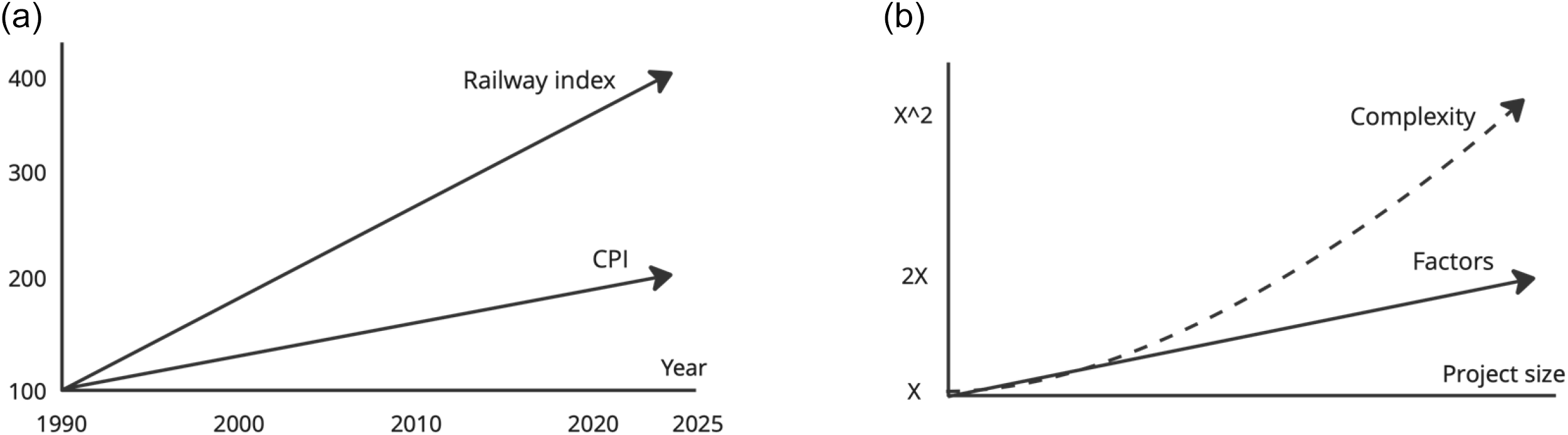

Figure 1. (a) Schematic illustration of the cost for railway investments compared to the Consumer Price Index (CPI) over 35 years (Statistics Sweden, 2025; Swedish Transport Administration, 2025); (b) Schematic illustration of how project complexity increases disproportionally with the number of interacting factors

Figure 1

Table 1. Complexity frameworks that are included in this study

Figure 2

Table 2. Project complexity frameworks and the main categories

Figure 3

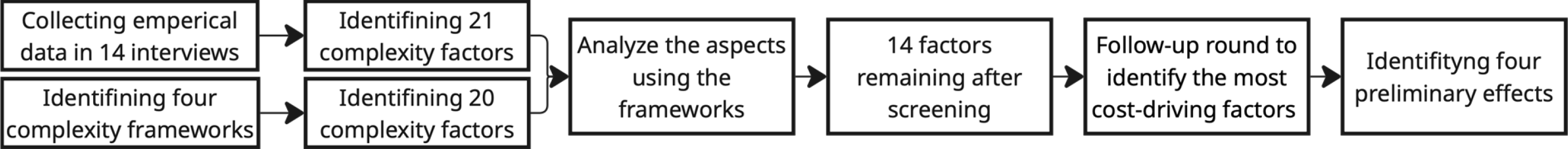

Figure 2. The main steps conducted in the study

Figure 4

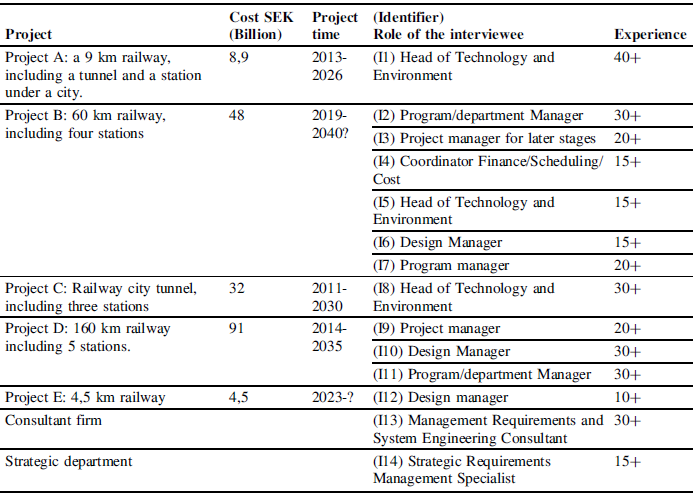

Table 3. The participants in the interview study and the project they are involved in (Trafikverket, 2021–2025). Costs are expressed in 2021 price levels, except for Project C and Project E, where costs are presented in 2009 and 2019 price levels, respectively

Figure 5

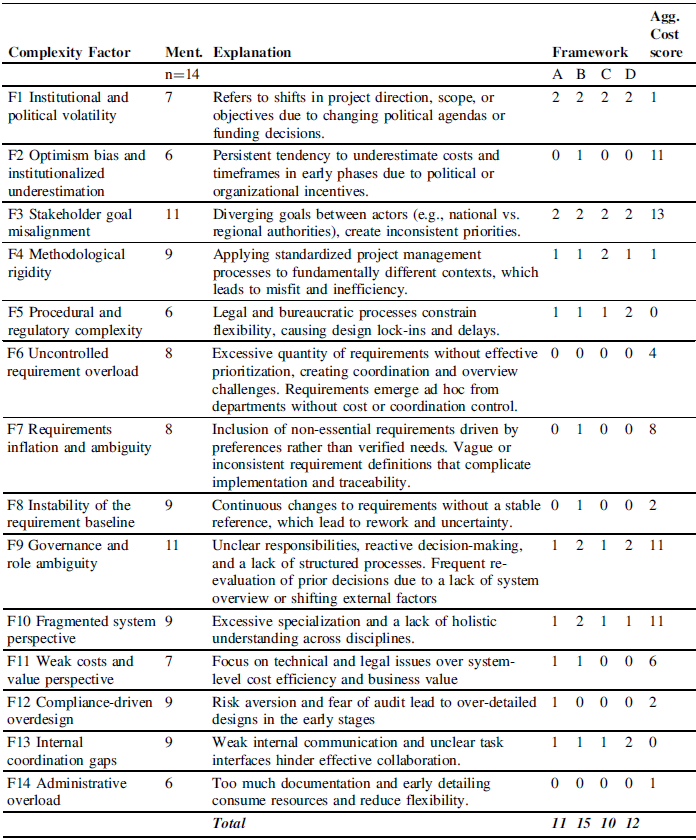

Table 4. Comparison between empirically identified complexity factors and their coverage in existing frameworksTable 4 long description.

Figure 6

Figure 3. Project complexity arises from interactions among complexity factors and their effects
